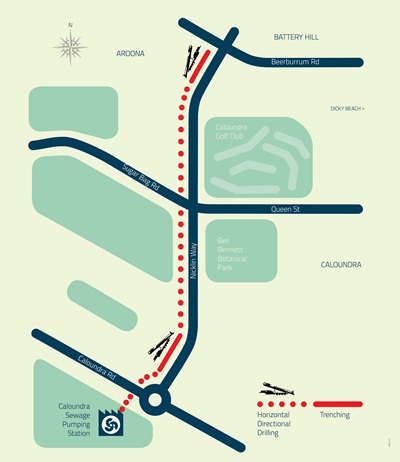

Caloundra timeline
Apr 2017
Drilling commenced along Nicklin Way
Nov 2017
Pipe installation along Nicklin Way completed
May 2018
Drilling under Caloundra Road completed
July 2018
Construction completed

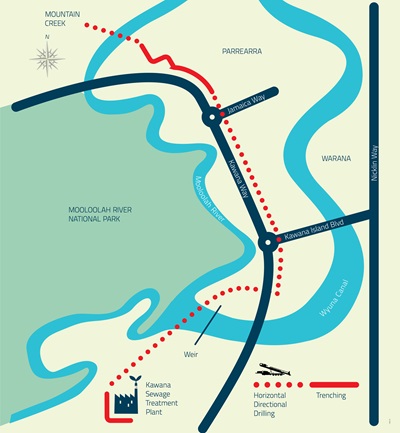

Mountain Creek to Kawana timeline
Jan 2017
Project commenced
Mar 2017
Wyuna Canal drill completed
Oct 2017
Mooloolah River drill commenced
Dec 2017
Kawana Way drill commenced
July 2018
Construction completed
